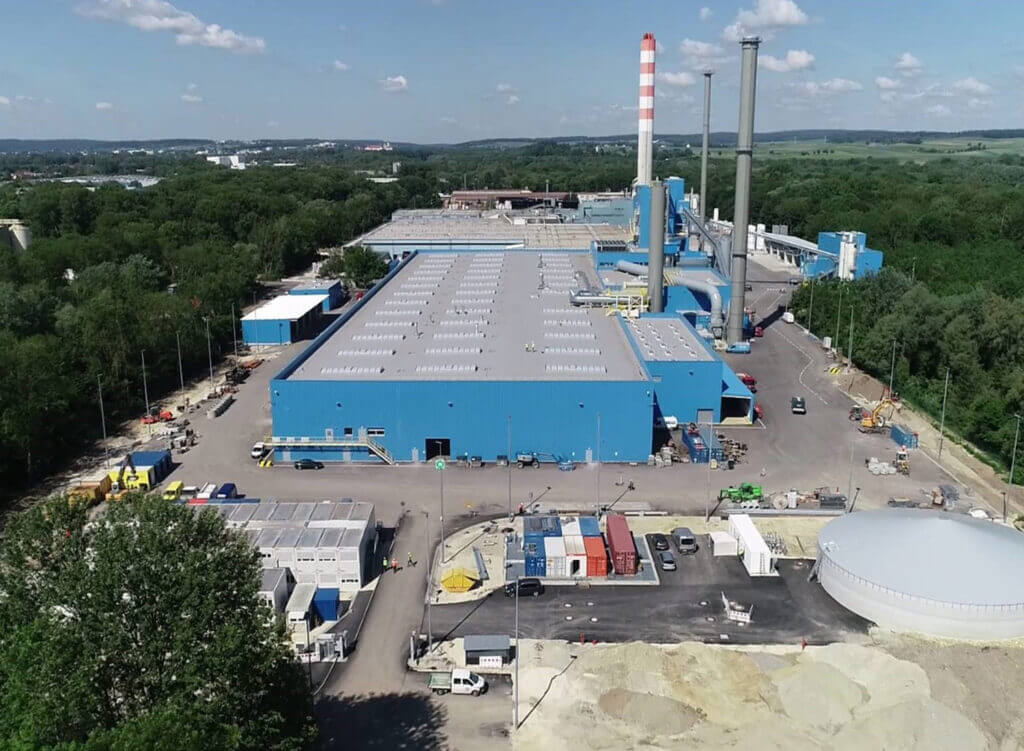

Rockwool Neuburg: Construction in Record Time – Despite the Pandemic

Conversion Under Full Operation

The project began inconspicuously on a gray February day in early 2018.

The two of us, Peter Struck and Moritz Bundschuh, drove to a new client to discuss geotechnical investigations and potentially provide further support. It quickly became clear that this project would be larger and more challenging than initially expected. The client was Rockwool, who wanted to comprehensively modernize a site while production was ongoing. The company produces, among other things, stone wool, which is used for insulation purposes.

The schedule was tight, the conditions demanding, and there was no lead time for the project. When asked whether we could start immediately, we had to swallow briefly – and then got going with full force. No sooner said than done: we submitted our references and met less than two weeks later with Rockwool’s newly installed project management in Copenhagen. The company’s goal was to start production with the new facilities in spring 2020. However, a production hall and its storage areas were still in operation on site. We had to operate on an open heart and also saw several challenges for Rockwool.

We asked Rockwool’s project manager whether they were aware that they would double production but also lose 80 percent of their storage space. They replied with a smile that it would actually be 100 percent of the storage space. At that point, it was clear that we understood each other. We began the conversion together with combined efforts. At the same time, we were competing with a sister project in the US. The rule was: whoever finished first would go into production. However, the sister project had a head start of six months.

We quickly took on the following tasks:

Geotechnical investigation and planning Demolition planning for buildings and storage areas Redesign, expansion, and modernization of existing storage areas and their more efficient use Finding partners for the client Developing and coordinating logistics concepts Creating and coordinating schedules without disrupting ongoing production Redesignating storage areas and integrating them with existing production Preparing and submitting permits, creating compensation areas Finalizing planning Preparing bills of quantities Conducting bidder discussions and selecting partners Managing the construction site And not least: communication, communication, communication

In December 2018, the time had come: the construction site was cleared, contracts were awarded, and in January 2019 the construction company began its work. By May, the first steel beams were in place. The topping-out ceremony for the first hall was held six weeks later. In October, the first halls were heated and installation of the equipment began. By February 2020, we were on the home stretch. Initial production test runs were successful. No one was talking about COVID yet.

In mid-March 2020, our Danish colleagues were suddenly no longer able to enter the country. The construction site quickly emptied, as the workers, mainly from Eastern Europe, understandably wanted to return to their families – preferably without having to spend two weeks in a quarantine camp. In the end, however, COVID was just another challenge that we were able to tackle and solve as a team.

English, German, and Danish were spoken on the construction site – yet communication worked. A certain amount of humor, as well as persistence, experience, innovation, and state-of-the-art technology, helped bring the project to a successful conclusion. From GINGER HPC’s side, we supported our colleagues in Denmark with regular drone flights, among other things. With a phone to our ear, we shared detailed photos of the construction site and reported on the progress of the work. We flexibly adapted the construction process to comply with COVID-19 regulations. For example, we completed outdoor facilities when the site was temporarily quiet due to partial lockdown.

In May 2020, we received the following message from our project manager, along with images of the first Rockwool produced at the new facility.

Message from the Project Manager

I am very proud of what we have achieved in a short time in the NEU 9 project! Today’s production of the first wool is a milestone that we have all reached with great effort – and this result is based on excellent collaboration and brings us closer to the finish line. Testing in general, including the most demanding tests, will continue in the coming period. Let us use this great moment to gather the energy for the final sprint toward the handover to Rockwool GmbH.

There is little to add to that: we are also proud of what has been achieved and look forward to the next steps in the project.

Client:
Rockwool
Project start:
Feb 2018
Project duration:
2 Years

Our strength – effective networking for power line expansion

Efficient planning and implementation of large-scale projects require collaboration—across locations and well-coordinated. Through networked collaboration, we are driving the expansion…
Learn more

Better air, healthier living: a focus on indoor air quality and mould control

Existing buildings tell their very own stories – whether through their construction, their ongoing use or the alterations made over…
Learn more

Tailor-made expertise for complex mining projects

Mining projects require a balance between technical excellence, environmental protection and social acceptance. With our multidisciplinary expertise, we are your…
Learn more

Future-proof water management: Rockflow in action at the Neuburg logistics centre

An innovative rainwater management solution was implemented for Rockwool’s new logistics centre in Neuburg. We were responsible for geotechnical engineering,…
Learn more

Safe demolition of the P+R car park in Filderstadt-Bernhausen

The P+R car park in Filderstadt-Bernhausen was partially demolished during the first construction phase in 2024 for structural reasons. This…
Learn more

Contaminated site remediation: groundwater protection at the former Rütgers Works

Protecting our environment requires perseverance and foresight – particularly in the case of historical contamination that has built up over…
Learn more

The new primary school at Baakenhafen

A primary school has been built right on the Baakenhafen, on one of Hamburg’s most challenging building sites. This project…
Learn more

Underground cabling: GINGER HPC as an advocate for soil and construction companies

The urgency of grid expansion to drive the energy transition has become particularly evident due to the Ukraine war. While…
Learn more

Building between two water levels

Hamburg’s HafenCity is one of the most impressive urban development projects in the city: since 2001, an entirely new district…
Learn more

Following the water: General drainage plan for Meerbusch

The task was clear: the general drainage plan, now 20 years old, needed to be updated. Not only were there…
Learn more

In-situ: Removed as if by magic

Volatile halogenated hydrocarbons are difficult to remove from soil. Bernadette Bohnert and her team used an innovative method for contaminant…
Learn more

Rockwool Neuburg: Construction in Record Time – Despite the Pandemic

The project began inconspicuously on a gray February day in early 2018. The two of us, Peter Struck and Moritz…
Learn more

Why work with us?

More than 75 years of experience

Since 1948, GINGER HPC has combined expertise and precision in environmental and engineering projects – ensuring reliable solutions that stand the test of time.

Strong international network

With offices across Europe, as part of the Ginger Group and as a founding member of the Inogen Alliance, we bring global insights and local expertise to every project.

Highest Quality Standards

Our solutions deliver technically flawless results, well-thought-out details, and an uncompromising commitment to quality at every stage of your project.

Our Service Areas

Land Recycling

Land Recycling

Experience. Responsibility. Worldwide.

Life is constantly evolving. New buildings and installations are emerging on freely available land. Elsewhere occupied land is being redeveloped and…

Environment and Safety

Environment and Safety

Experience. Responsibility. Worldwide.

The environment and our living conditions determine our quality of life. Development entails changes. Environmental development is the result of many…

Infrastructure

Infrastructure

Experience. Accountability. Valorisation.

Regional economic objectives of investment-related infrastructure policies can only be achieved by thorough infrastructure planning. Infrastructure…

Cookie Consent with Real Cookie Banner
