Back on Track: New Pipelines for Clean Water

Rehabilitation of the Wastewater Systems in Spittal/Drau

60 years that is roughly the service life of sewer systems. Why does that matter? When wastewater no longer flows properly, it can escape from the system and contaminants may enter the groundwater. This can have serious consequences for both people and the environment. To prevent this, the municipality of Spittal/Drau commissioned a comprehensive rehabilitation of its wastewater systems.

Precise preliminary work – the key to success
Under the direction of HPC IBK, the entire combined sewer system was first examined, including pumping stations, combined sewer overflow structures and retention basins. This involved not only inspecting the existing sewer network but also measuring flow and precipitation volumes as well as assessing the impact on groundwater and surface water.

The result: significant hydraulic deficiencies had to be addressed immediately. Based on the hydraulic and structural assessment of the inspected sewers, the ecological situation and the possible future development of the system, a comprehensive rehabilitation plan was developed and implemented over a period of almost three years.

Implementation – Following the Path of the Sewers

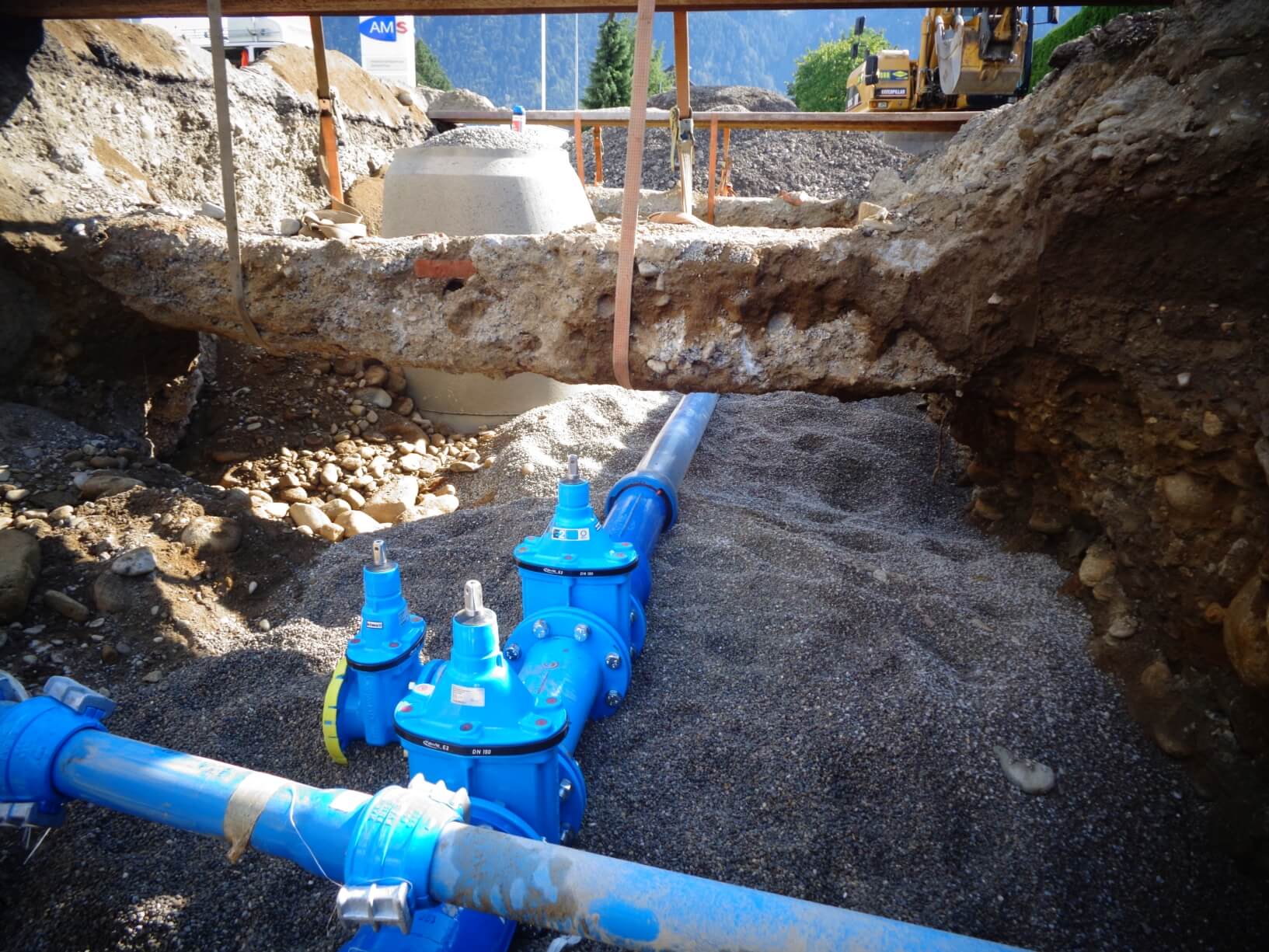

Leaking and outdated sewer systems were rehabilitated using two different methods. In some sections, underground repairs were carried out using trenchless lining techniques (inliner method), which allow renewal within the existing pipes. In other areas, trenches were excavated and the pipes were completely replaced.

While these tasks themselves posed no difficulty for our experienced specialists, the team faced a very different challenge.

Clean into the Future

After only three years of planning and implementation, parts of the sewer system in Spittal/Drau are now operating like new again. The system has been upgraded to the latest state of the art, and in the long term the municipality will benefit from reduced operating and maintenance costs.

Once again, our team has demonstrated that we combine technical expertise with a strong focus on sustainability.

The major challenge in this project lay in the extremely limited space and accessibility on site. In the western and eastern construction areas, the new daycare center building directly borders neighboring buildings that are still under construction. To the north and south, the excavation pit directly adjoins public spaces: on one side there is a tartan running track where neither construction vehicles can drive nor building materials can be stored. On the other side, the only access to the construction site is a one-way street with adjacent cycling and pedestrian paths. This means that extensive work, such as excavation, had to be organized under one-way traffic conditions.

This created major logistical challenges, not least when installing the water treatment plant required for groundwater lowering. Since there was very little space available around the excavation pit, the plant was installed 250 meters away on a plot of land where construction had not yet begun. A complex task in whose planning and implementation GINGER HPC was involved. In doing so, we made a significant contribution to preventing contamination of the Elbe River and the groundwater.

In the meantime, buoyancy protection for the new building is ensured by its own weight and additional structural load. As a result, the groundwater management system has been successfully completed and dismantled.

And Now? Moving into the Future with Sustainability

The space along the sides of the excavation pit is available for backfilling. It is planned to fill the southern shoring area, under the professional supervision of GINGER HPC, with flowable fill (liquid soil) up to 1.5 m below ground level. The sandy backfill to be placed above will be flushed in with water. During this process, the timber lagging will be gradually removed.

Finally, the public areas such as roads, pedestrian and cycle paths, as well as infrastructure including sewer lines for wastewater and stormwater, will be inspected through comprehensive elevation surveys, compaction tests and CCTV inspections of the pipelines. GingerHPC plans and initiates the required evidentiary safeguarding measures, carries out some of them directly, and evaluates the results.

The project remains an exciting one for GINGER HPC. Following the successful excavation of the construction pit, structural construction works are now in full progress. Our team of experienced engineers continues to support the project with expert advice on geotechnical and environmental matters.

One of the next tasks will be the dismantling of the excavation support system, which consists of a braced Berlin-type shoring system on the north side and a double-anchored Essen-type shoring system on the south side. Extremely tight space conditions in the area alongside the excavation pit—locally only about 10 cm between the new building and the soldier pile shoring—pose particular challenges, especially on the south side, when backfilling the approximately 5-metre-deep space.

Client:
Municipality of Spittal an der Drau
Project duration:
3 Years
Project location:
Austria

Practical Guide to Selective Demolition and Renovation of Existing Buildings

Resource-efficient approaches are becoming increasingly important in the refurbishment of existing buildings. The ‘Practical Guide to Selective Demolition and Refurbishment…
Learn more

Energy for the future: Our contribution to Hamburg’s largest battery storage facility

The go-ahead has been given for Hamburg’s largest battery storage facility. Our branch in Soest has drawn up the planning…
Learn more

Our strength – effective networking for power line expansion

Efficient planning and implementation of large-scale projects require collaboration—across locations and well-coordinated. Through networked collaboration, we are driving the expansion…
Learn more

Better air, healthier living: a focus on indoor air quality and mould control

Existing buildings tell their very own stories – whether through their construction, their ongoing use or the alterations made over…
Learn more

Tailor-made expertise for complex mining projects

Mining projects require a balance between technical excellence, environmental protection and social acceptance. With our multidisciplinary expertise, we are your…
Learn more

Future-proof water management: Rockflow in action at the Neuburg logistics centre

An innovative rainwater management solution was implemented for Rockwool’s new logistics centre in Neuburg. We were responsible for geotechnical engineering,…
Learn more

Safe demolition of the P+R car park in Filderstadt-Bernhausen

The P+R car park in Filderstadt-Bernhausen was partially demolished during the first construction phase in 2024 for structural reasons. This…
Learn more

Contaminated site remediation: groundwater protection at the former Rütgers Works

Protecting our environment requires perseverance and foresight – particularly in the case of historical contamination that has built up over…
Learn more

The new primary school at Baakenhafen

A primary school has been built right on the Baakenhafen, on one of Hamburg’s most challenging building sites. This project…
Learn more

Underground cabling: GINGER HPC as an advocate for soil and construction companies

The urgency of grid expansion to drive the energy transition has become particularly evident due to the Ukraine war. While…
Learn more

Building between two water levels

Hamburg’s HafenCity is one of the most impressive urban development projects in the city: since 2001, an entirely new district…
Learn more

Following the water: General drainage plan for Meerbusch

The task was clear: the general drainage plan, now 20 years old, needed to be updated. Not only were there…
Learn more

Why work with us?

More than 75 years of experience

Since 1948, GINGER HPC has combined expertise and precision in environmental and engineering projects – ensuring reliable solutions that stand the test of time.

Strong international network

With offices across Europe, as part of the Ginger Group and as a founding member of the Inogen Alliance, we bring global insights and local expertise to every project.

Outstanding Quality

Our quality speaks for itself: Awards such as the EcoVadis Silver 2026, as well as ISO 9001 and 14001 certifications, underscore our high standards. They symbolize trust, efficiency, and quality – values that have guided us from the very beginning.

Our Service Areas

Land Recycling

Land Recycling

Experience. Responsibility. Worldwide.

Life is constantly evolving. New buildings and installations are emerging on freely available land. Elsewhere occupied land is being redeveloped and…

Environment and Safety

Environment and Safety

Experience. Responsibility. Worldwide.

The environment and our living conditions determine our quality of life. Development entails changes. Environmental development is the result of many…

Infrastructure

Infrastructure

Experience. Accountability. Valorisation.

Regional economic objectives of investment-related infrastructure policies can only be achieved by thorough infrastructure planning. Infrastructure…

Cookie Consent with Real Cookie Banner
